Serving Los Angeles County / CSLB #1117837 / HCD #DL1611393Call 1-888-637-8238Free 48-hour lot check
All ADU services

New build

Detached ADUAttached ADUTwo-Story ADUPrefab / Modular ADUCasita / Granny Flat

Conversions

Garage ConversionJunior ADU (JADU)ADU Above GarageUnpermitted ADU LegalizationMultifamily ADU

Design, permits & money

Ground-Up ConstructionDesign & PermitsADU Floor PlansFinancing & ReturnsAll service areas

San Fernando Valley

Sherman OaksVan NuysNorth HollywoodStudio CityWoodland HillsEncinoNorthridge

San Gabriel Valley & east

PasadenaGlendaleBurbankSilver Lake

Westside & South Bay

Santa MonicaCulver CityInglewoodTorranceLong Beach

Guides

All guidesADU Cost in Los Angeles: What It Actually Runs in 2026California ADU Laws and What They Mean in Los AngelesSB 9 in California: Lot Splits and How They Compare to an ADUHow Long Does It Take to Build an ADU in Los Angeles?Does an ADU Increase Property Value in Los Angeles?Detached ADU vs Garage Conversion: Which Suits Your LA Lot?ADU Setback Requirements in California: The Four-Foot Rule ExplainedThe LA ADU Standard Plan Program: Pre-Approved Designs ExplainedBuilding a Hillside ADU in Los Angeles: What the Slope Really CostsADU Kitchen Requirements and Utility Rules in Los Angeles

Company

AboutContactGet a free lot check

Process / 8 min read

How Long Does It Take to Build an ADU in Los Angeles?

How long does it take to build an ADU? Nine to twelve months from first call to certificate of occupancy for a detached unit in Los Angeles. Here is the month-by-month breakdown and the five things that actually cause delays.

The short answer

How long does it take to build an ADU? Nine to twelve months from first call to certificate of occupancy for a detached unit in Los Angeles. Here is the month-by-month breakdown and the five things that actually cause delays.

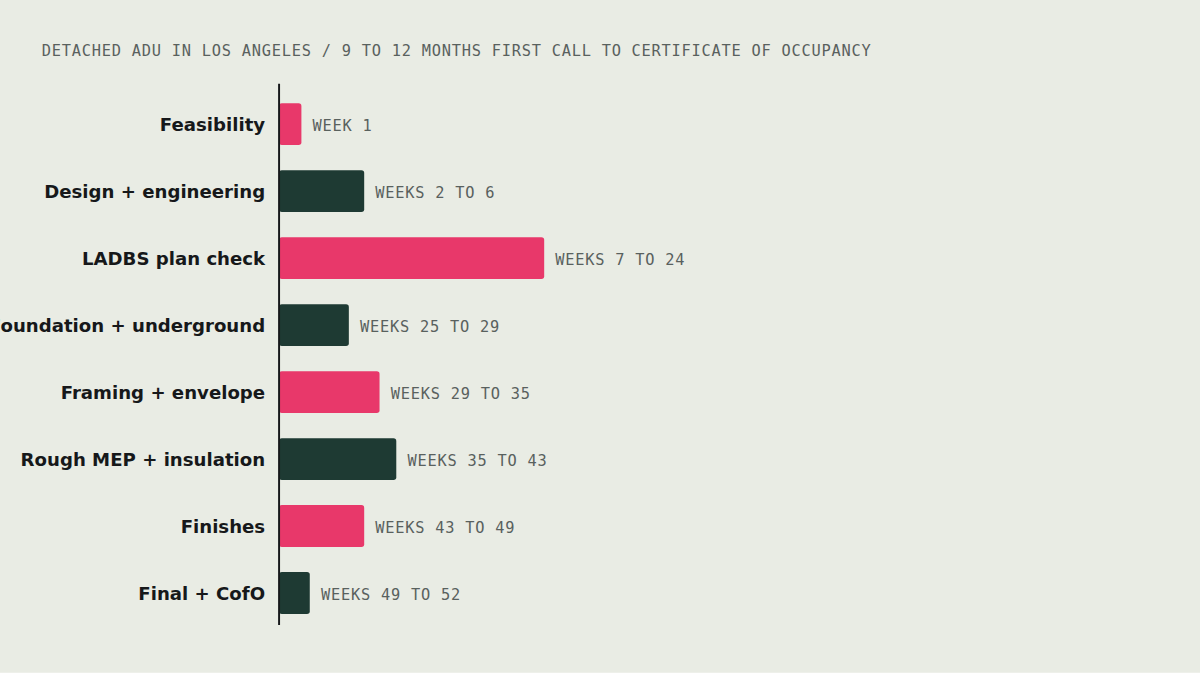

DETACHED ADU IN LOS ANGELES / 9 TO 12 MONTHS FIRST CALL TO CERTIFICATE OF OCCUPANCYFeasibilityweek 1Design + engineeringweeks 2 to 6LADBS plan checkweeks 7 to 24Foundation + undergroundweeks 25 to 29Framing + envelopeweeks 29 to 35Rough MEP + insulationweeks 35 to 43Finishesweeks 43 to 49Final + CofOweeks 49 to 52DETACHED ADU IN LOS ANGELES / 9 TO 12 MONTHS FIRST CALL TO CERTIFICATE OF OCCUPANCY
How Long Does It Take to Build an ADU in Los Angeles?

Nine to twelve months, first call to certificate of occupancy, for a detached ADU in Los Angeles. A garage conversion runs about three months shorter. Anyone promising six months for a ground-up detached unit is either not counting the permit or is about to disappoint you.

The counterintuitive part is that construction is not the long pole. Design and plan check take roughly as long as the build, and they are the phase where delays are hardest to recover.

Month by month, detached ADU

PhaseDurationWhat happens
FeasibilityWeek 1Parcel study, site visit, soils review, sewer camera
DesignWeeks 2 to 6Architectural set, structural calcs, Title 24, owner approval
Plan check submittalWeek 7Filed with LADBS
First plan check responseWeeks 11 to 15Corrections come back
Correction cyclesWeeks 15 to 22One to two cycles, 2 to 4 weeks each
Permit issueWeeks 22 to 24Clearances, fees paid, permit pulled
Foundation and undergroundWeeks 25 to 29Excavation, footings, plumbing rough, slab
Framing and envelopeWeeks 29 to 35Framing, shear, roof, windows, exterior
Rough MEPWeeks 35 to 39Electrical, plumbing, mechanical, three inspections
Insulation and drywallWeeks 39 to 43Title 24 HERS verification, nail inspection, tape
FinishesWeeks 43 to 49Flooring, cabinets, fixtures, paint, appliances
Final and CofOWeeks 49 to 52Final inspection, utility connection, certificate

Garage conversion timeline

Roughly 6 to 7 months total. Design runs 3 to 4 weeks instead of 5, plan check is lighter because the structure exists, and construction is 3 to 4 months rather than 5 to 7. The variable that can blow it up is ceiling height: if the existing structure sits below 7 feet 6 inches, raising the roof adds structural work and puts the timeline back toward a new build.

The five things that actually cause delays

1. An incomplete first submittal

This is the single biggest one. A submittal missing a Title 24 report, a structural calc page or a required stormwater sheet does not get a partial review. It gets a correction letter listing what is missing, and you have lost four to eight weeks for nothing.

2. Utility scheduling

LADWP service upgrades run on their own calendar. If the ADU needs a 200-amp upgrade, get in the queue at permit issue, not when the electrician is ready. Owners routinely lose a month here.

3. Owner-driven design changes after permit

Moving a wall after the permit is issued means a revision submittal and another review cycle. Changes are effectively free during design and expensive after plan check. This is why we hold a formal owner approval before filing.

4. Inspection scheduling

LADBS inspection availability varies through the year and can add several days per stage. Across eight inspected stages that compounds into weeks. Filing the request the same afternoon a stage completes is the only real lever.

5. Long-lead materials

Windows, custom cabinetry and some HVAC equipment can run 10 to 16 weeks. Ordering them at permit issue rather than when the framing is done is the difference between them arriving early and them stopping the job.

What can be run in parallel

  • Financing approval runs alongside design, not after it
  • Soils report and sewer camera run during the first week, not after design
  • Prefab factory build runs concurrently with plan check, which is where prefab genuinely wins on schedule
  • Long-lead material ordering starts at permit issue
  • LADWP service upgrade application is filed at permit issue

The Standard Plan shortcut

Los Angeles pre-approves a set of ADU designs through its Standard Plan Program. Using one removes the architectural plan check entirely, leaving only site-specific review. That typically saves about six weeks and around $6,000. The constraint is that a pre-approved plan has to fit your lot's setback geometry, which is the first thing to check.

Find out what your lot allows

Free 48-hour lot check

Send the address. We do the parcel research.

No site visit needed. We answer within 48 hours. Or call 1-888-637-8238.

Common questions

Can an ADU be built in six months in Los Angeles?

A garage conversion, sometimes, if the design is simple and plan check goes cleanly. A ground-up detached ADU, essentially never, because permitting alone typically consumes three to five months.

What is the longest part of the process?

LADBS plan check, at three to five months including correction cycles. It is longer than most people expect and longer than the framing and envelope phase of construction.

Can I speed up plan check?

Yes, in two ways. File a genuinely complete first submittal, which is the biggest single lever. And use a Los Angeles Standard Plan if one fits your lot, which removes the architectural review entirely.

Do I need to move out during construction?

No for a detached ADU. Attached ADUs and junior ADUs involve short periods of noise and scheduled utility shutoffs, but almost nobody needs to move out for either.
